If your organization approved AI infrastructure investments in late 2025 but you're still evaluating deployment options, you're not alone. The challenge is that evaluation paralysis comes with a steep cost: every month of delay pushes your deployment timeline deeper into the following year using traditional approaches.
According to Gartner's October 2025 forecast, AI infrastructure spending will reach $280 billion in 2026, with datacenter systems growing 19% to $582.4 billion. The enterprises capturing this market opportunity are those deploying infrastructure in 4 to 8 months, not 18 months.
The AI Infrastructure Planning Crisis
Most infrastructure teams face the same dilemma: they need GPU-ready capacity on compressed timelines, targeting near-term production windows rather than completion dates two years out, but traditional data center builds require 18 to 24 months from planning to production. The math doesn't work.
| Constraint | What the data shows |
|---|---|
| Traditional data center build | 18 to 24 months average (Uptime Institute, 2025) |
| Equipment lead times | Long lead times for critical components including generators, switchgear and chillers (Uptime Institute, 2025) |
| Project delays and cost overruns | Delays and overruns are common on large data center builds. Price each path on the same written scope before comparing totals. |
The competitive pressure is real. AI-optimized Infrastructure-as-a-Service spending is projected to grow from $18.3 billion in 2025 to $37.5 billion in 2026, more than doubling year over year according to Gartner. Companies that secured GPU-ready infrastructure early are capturing market share while competitors are still negotiating construction contracts.
The Critical Decision Window
The window to commission infrastructure for near-term production has narrowed significantly. Projects starting now with traditional builds will not complete for 18 to 24 months at the earliest. Here's why: even with aggressive timelines, traditional builds require 18 to 24 months from ground-break to go-live.
Infrastructure Procurement Lead Times
The Uptime Institute's 2025 Global Data Center Survey identified equipment availability as a top concern. Critical components face unprecedented lead times:
| Equipment | Lead time |
|---|---|
| Generators | 12 to 16 months |
| Switchgear | 14 to 18 months |
| Large chillers | 12 to 15 months |
| UPS systems | 10 to 14 months |
| Transformers | 12 to 16 months |
Source: Uptime Institute, Global Data Center Survey 2025, equipment lead times and cost concerns.
Equipment orders placed today carry long delivery windows. Add construction time, commissioning, and inevitable delays, and production deployment lands well over a year out on a traditional path.

AI Infrastructure Planning Checklist
Before evaluating deployment options, conduct a thorough requirements assessment. This 47-point checklist covers the critical decision factors:
Power Requirements Assessment
- Total Power Capacity: Calculate kW per rack and total MW requirements
- Power Density: Modern GPU racks require far more per rack than the 10 to 15 kW traditional halls were built for
- Redundancy: Match redundancy to the workload. Options run from N to N+1 to 2N.
- Utility Availability: Dual utility feeds, adequate transformer capacity
Cooling Methodology Selection
- Air Cooling Limits: Traditional CRAC units max out at about 15 kW per rack
- Liquid Cooling Requirements: Direct-to-chip liquid cooling is required at high GPU rack density
- PUE Targets: At high density, liquid cooling lowers overhead compared with air cooling. Compare facilities on the same IT load and contract term.
Timeline and Budget Constraints
- Target Operational Date: When do you need production capacity online?
- Budget Flexibility: Can the budget absorb the overruns that are common on large builds?
- Opportunity Cost: What's the revenue impact of a 6 to 12 month deployment delay?
Deployment Paths Compared
Four primary deployment strategies exist for AI infrastructure in 2026. Each offers distinct trade-offs in timeline, cost, control, and risk:
Option 1: Traditional Data Center Build
Advantages
- Full ownership and control
- Custom design for specific needs
- Long-term asset value
- Unlimited scaling potential on-site
Disadvantages
- 18 to 24 month deployment timeline
- $8M to $12M per MW capital investment
- Cost overruns are common on large builds
- Construction and design risk
- Requires facility management expertise
Best for: Organizations with planning horizons of 24 months or more, internal data center expertise, and budgets that can absorb significant overruns.
Cost: $8M to $12M per MW (Cushman and Wakefield, 2025), up to $20M or more for AI-optimized facilities
Timeline: 18 to 24 months minimum, with delays common
Option 2: Modular Data Center Deployment
Advantages
- 4 to 8 month deployment timeline
- Factory-tested before delivery
- Designed for high-density GPU racks
- Incremental capacity expansion
- Full ownership after deployment
Disadvantages
- Still requires site preparation
- Limited customization options
- Standardized configurations
- Requires adequate site infrastructure
Best for: Organizations needing near-term deployment, seeking ownership without construction risk, requiring GPU-ready infrastructure.
Cost: Varies by capacity, site scope and equipment reservation. Compare each path on the same written scope, including site works and commissioning.
Timeline: Ready for service in 4 to 8 months, depending on equipment reservation and site readiness. From order to modules delivered on site takes 3 to 6 months.
Industry examples: Google's container data centers, Microsoft Azure modular facilities, Schneider Electric EcoStruxure deployments
Option 3: Enterprise Colocation
Advantages
- Faster where rack-ready space already exists
- Facility capital borne by the operator
- Professional facility management included
- Contract service levels vary by operator and agreement
- Compliance certifications in place
Disadvantages
- Monthly OpEx against CapEx
- Less control over infrastructure
- Contract terms and commitments
- Legacy facilities may not support GPU density
Best for: Immediate capacity needs, avoiding CapEx, lacking internal facilities expertise, testing infrastructure strategy before major investment.
Cost: Monthly charges vary by market, density, services included and contract term.
Timeline: Where rack-ready space already exists, deployment is faster than a new build. A Syaala colocation position is 4 to 8 months from Service Order to ready for service, by position, on power-ready sites in Texas, the Southeast and the Mid-Atlantic.
Option 4: Hybrid Deployment Strategy
Many enterprises are adopting a phased approach: start with colocation for immediate needs, deploy modular data centers for medium-term capacity, and maintain cloud for burst workloads and geographic distribution.
- Phase 1 (where rack-ready space already exists). Deploy in an enterprise colocation facility where rack-ready space already exists.
- Phase 2 (4 to 8 months). Add modular data center capacity for owned infrastructure.
- Phase 3 (ongoing). Maintain cloud for geographic distribution and burst capacity.
Real Deployment Timeline: Modular Against Traditional
Let's compare actual timelines for a 2 MW AI infrastructure deployment using both traditional and modular approaches:
| Phase | Modular Data Center | Traditional Build |
|---|---|---|
| Requirements and vendor selection | Scope and site fit confirmed | Month 1 to 2 |
| Design and permitting | Module design and site permitting for the modular scope | Month 3 to 6 |
| Equipment procurement | Equipment reserved as part of the order | Month 7 to 18 |
| Site preparation | Site preparation, running in parallel with the factory build | Month 6 to 9 |
| Construction and manufacturing | Factory build, running in parallel with site preparation | Month 9 to 20 |
| Testing and commissioning | Delivery, installation and commissioning | Month 21 to 24 |
| Total timeline | 4 to 8 months | 18 to 24 months |
| Typical delays | Site gates such as energisation, fibre and permits can pace the date | Delays beyond the original timeline are common |
The modular advantage comes from parallelization: while your site is being prepared, the module is being manufactured and tested in a factory environment. Traditional builds are sequential: each phase must complete before the next begins.

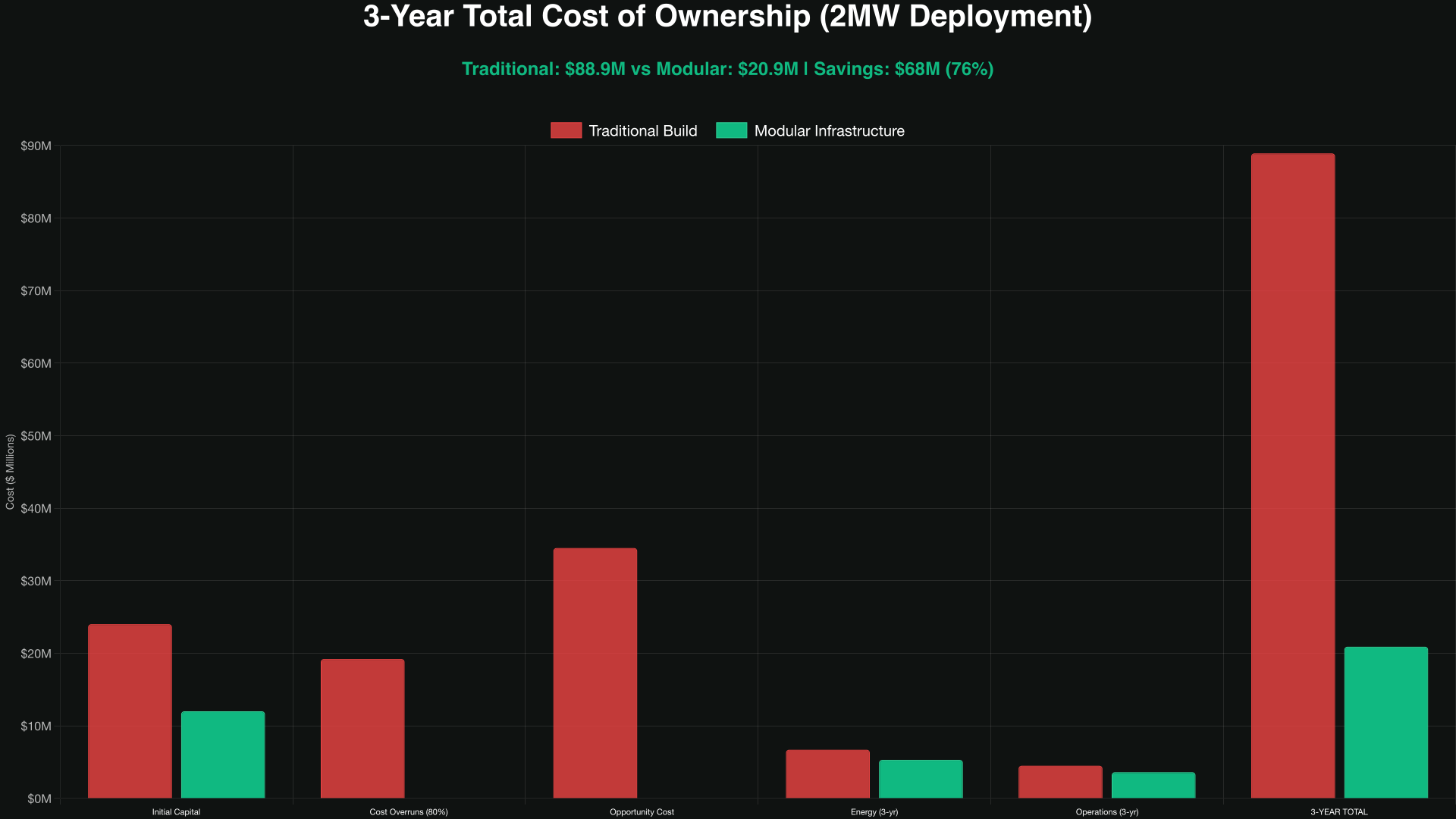

ROI Analysis and Total Cost of Ownership
Understanding true total cost of ownership requires looking beyond initial capital expenditure to include opportunity costs, operational efficiency, and risk factors:
Opportunity Cost of Delayed Deployment
Every month of delay postpones the point at which capacity can enter service. A traditional build starting today reaches operation materially later than a modular deployment that is ready for service in 4 to 8 months, so the waiting period before capacity is available is longer on the traditional path.
Construction Cost Overrun Risk
Large construction projects commonly face cost overruns. Factory build and site preparation running in parallel can reduce on-site construction exposure compared with a fully site-built programme. Site scope still has to be priced and confirmed in writing for either path.
Comparing Total Cost on the Same Scope
Total cost depends on site scope, equipment reservation, power price and contract term, so a like-for-like comparison needs the same written scope for each path.
Industry Examples: Modular in Production
Modular data center infrastructure isn't experimental. Global technology leaders have deployed container-based and modular facilities at scale:
Google's Container Data Centers
Google pioneered container-based data center design, deploying shipping container modules with pre-integrated servers, networking, and cooling. This approach enables rapid deployment and standardized operations across global facilities.
Source: Google data center public documentation, Data Center Knowledge archives
Microsoft Azure Modular Facilities
Microsoft uses modular construction techniques for Azure expansion. Standardized modules enable consistent quality across regions.
Source: Microsoft Azure blog, industry press releases
Schneider Electric EcoStruxure Modular
Schneider Electric's prefabricated data center modules serve enterprise clients across telecommunications, healthcare, and financial services, with factory testing as part of the programme.
Source: Schneider Electric public case studies
EdgeConneX Modular Edge Facilities
EdgeConneX deployed more than 40 edge data centers using modular and prefabricated components, achieving consistent quality and accelerated timelines. Standardization enables rapid scaling across markets.
Source: EdgeConneX press releases, Data Center Dynamics
These examples demonstrate that modular infrastructure is not just viable but preferred by organizations that prioritize speed, cost certainty, and operational efficiency. The technology is proven at hyperscale and now available to enterprises without hyperscaler budgets.
Your 2026 Infrastructure Decision
The path you choose determines your competitive position for the next 24 months. Here's how to make the decision:
- Assess your timeline requirements. When do you need production capacity operational? If the answer is within the next year, traditional builds are not viable. Modular or colocation are the realistic options.
- Calculate true total cost of ownership. Use the interactive TCO calculator to model your specific scenario. Include opportunity costs, overrun risk, and operational efficiency differences.
- Evaluate internal capabilities. Use the AI Readiness Checklist to honestly assess whether your team has data center construction and operations expertise.
- Consider hybrid approaches. You don't need to choose just one path. Many enterprises start with colocation for immediate needs, add modular capacity for medium-term scale, and maintain cloud for geographic distribution.
- Make the decision explicitly. Every month of delay pushes the deployment timeline further out on every path. The cost of indecision is measurable in lost revenue and competitive disadvantage.
Conclusion
The 2026 AI infrastructure market is moving faster than traditional deployment timelines can support. Organizations that recognize this reality and adopt modular, colocation, or hybrid strategies will capture market share while competitors wait for traditional builds to complete.
With AI infrastructure spending reaching $280 billion in 2026 and growing 19% annually, the timeline advantage of modular deployment translates directly to competitive advantage. The question is not whether you'll deploy AI infrastructure, but whether you'll deploy it in time to matter.
Every month of delay moves the production date by a month on every path.
